• 검색 결과가 없습니다.

A Study on the Development of Work-Crew Based Daily-Productivity for Representative B.O.Q Item in River Conservation Project

N/A
N/A
Protected

Academic year: 2021

Share "A Study on the Development of Work-Crew Based Daily-Productivity for Representative B.O.Q Item in River Conservation Project"

Copied!
10
0
0

로드 중.... (전체 텍스트 보기)

전체 글

(1)

* ∊ᇢݡ⦺Ʊ ☁༊Ŗ⦺ᇡ ᕾᔍŝᱶ ([email protected])

Received January 22, 2013/ revised March 6, 2013/ accepted April 9, 2013

Copyright ⵑ 2013 by the Korean Society of Civil Engineers

This is an Open Access article distributed under the terms of the Creative Commons Attribution Non-Commercial License (http://creativecommons.org/licenses/by-nc/3.0)

 ǣŠ––’ǣȀȀ†šǤ†‘‹Ǥ‘”‰ȀͳͲǤͳʹ͸ͷʹȀ•…‡ǤʹͲͳ͵Ǥ͵͵Ǥ͸Ǥʹͷͳͻ

™™™Ǥ•…‡Œ‘—”ƒŽǤ‘”Ǥ”

㬖㉚ኳ♪#ᢾ㨚ኳ⹃ⴖ#ⵏ⮃⸮#ጪ⛯#⇍#⚛♮⛯#ⷓ⊲#ᇚ⇚

କ۴વ ȵࢮ෴ֽ ȵହ෴ࢢ

Yoo, Duk-Yul*, Park, Hyung-Keun**, Lim, Hyeong-Min***

A Study on the Development of Work-Crew Based

Daily-Productivity for Representative B.O.Q Item in River Conservation Project

ABSTRACT

The standard of estimate is being used as basic material for appropriating construction expenses of public institutions and private institutions. The present thesis aims to propose a new form of a standard of estimate and a calculation method of work amount of equipment by targeting a representative construction type selected at river reservation work. The present thesis expects that the convenience of users can be expanded by improving applicability of a standard of estimate and simplifying a calculation process of work amount of equipment in a process planning stage so that the provision of work crew lineup information and daily productivity information is possible by a standard of estimate. In case of river conservation work, because the variables called work conditions act very largely, there exists much difficulty for generalizing productivity information and work amount of equipment, but if its accuracy could be enhanced by improving continuous productivity information and work amount information of equipment, the simplification of process planning establishment and cumulative process through a standard of estimate would be possible.

Key words : Daily Productivity Information, Work-Crew, Standard of Estimate, Daily Quantity, Representative B.O.Q

Ⅹಾ

⢽ᵡ⣩ᖩᮡŖŖʑšၰၝeʑš᮹Ŗᔍእෝ₦ᱶ⦹۵ʑᅙᱢᯙᯱഭಽᯕᬊࡹŁᯩ݅. ᅙםྙᮡ⦹⃽Ŗᔍᨱᕽᖁᱶࡽݡ⢽Ŗ᳦ᮥݡᔢᮝಽ

ᔩಽᬕ⩶᜾᮹⢽ᵡ⣩ᖩၰᰆእ᮹᯲ᨦపᔑ⇽ႊ᜾ᮥᱽᦩ⦹Łᯱ⦽݅. ⣩ᖩᨱᕽ᯲ᨦ᳑Ǎᖒ᮹ᱶᅕၰ1ᯝᔾᔑᖒᱶᅕ᮹ᱽŖᯕa܆⦹ࠥಾ

⧉ᮝಽ៉Ŗᱶĥ⫮݉ĥᨱᕽ⣩ᖩ᮹ᱢᬊᖒᮥ⨆ᔢ᜽┅Łᰆእ᮹᯲ᨦపᔑ⇽ŝᱶᮥeᗭ⪵⦹ᩍᔍᬊᯱ᮹⠙᮹ᖒᮥ᷾ݡ⧁ᙹᯩʑෝʑݡ⦽

݅. ⦹⃽Ŗᔍ᮹Ğᬑ᯲ᨦ᳑Õᯕ௝۵ᄡᙹaๅᬑⓍí᯲ᬊ⦹ʑভྙᨱᔾᔑᖒᱶᅕၰʑĥ᮹᯲ᨦపᮥᯝၹ⪵⦹۵äᮡฯᮡᨕಅᬡᯕ᳕ᰍ

⦹ḡอḡᗮᱢᯙᔾᔑᖒᱶᅕ᪡ʑĥ᮹᯲ᨦపᱶᅕෝ}ᖁ⦹ᩍᱶ⪶ࠥෝ⨆ᔢ⧁ᙹᯩ݅໕⣩ᖩᮥ☖⦽Ŗᱶĥ⫮ᙹพၰᱢᔑŝᱶ᮹eᗭ⪵a

a܆⧁äᯕ݅.

áᔪᨕ ᯝᯝᔾᔑᖒᱶᅕ, ᯲ᨦ᳑, ⢽ᵡ⣩ᖩ, ᯝᯝ᯲ᨦప, ݡ⢽Ŗ᳦

‘•–”—…–‹‘ƒƒ‰‡‡– ֨ėěν

(2)

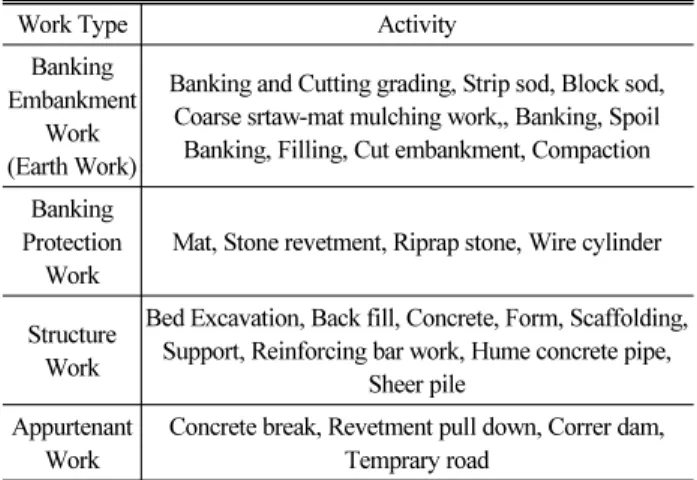

Table 1. Representative Classification of River Conservation Work

Work Type Activity

Banking Embankment

Work (Earth Work)

Banking and Cutting grading, Strip sod, Block sod, Coarse srtaw-mat mulching work,, Banking, Spoil

Banking, Filling, Cut embankment, Compaction Banking

Protection Work

Mat, Stone revetment, Riprap stone, Wire cylinder

Structure Work

Bed Excavation, Back fill, Concrete, Form, Scaffolding, Support, Reinforcing bar work, Hume concrete pipe,

Sheer pile Appurtenant

Work

Concrete break, Revetment pull down, Correr dam, Temprary road

1. ᕽು

1.1 ઴֜ࢼլࢫࡧୡ

⢽ᵡ⣩ᖩᮡŖŖʑšၰၝeʑš᮹Ŗᔍእෝ₦ᱶ⦹۵ʑᅙᱢ ᯙᯱഭಽᯕᬊࡹŁ ᯩ݅. ⩥ᰍ⢽ᵡ⣩ᖩᮡ12ᰆ⾶ࠥಽ᮹⡍ᰆ

ၰᮁḡ⾸ᇡᇥᨱᕽ᯲ᨦ᳑᪡1ᯝ᯲ᨦపᮥᱽ᜽⦹Łᯩ݅. ࠥಽ᮹

⡍ᰆၰᮁḡᇡᇥᮥᱽ᫙⦽ᇡᇥᮡ Ƌ

Ð

, Ƌ

Ï

, Ƌ , ᅙ॒݉᭥ྜྷపᨱ

঑௝⦥᫵⦽ᰍᬱᮥӹ┡ԕŁᯩ݅. ᯕ్⦽Ǎ᳑۵⦹൉ᨱᔾᔑa܆⦽

᯲ᨦపᔑ⇽ŝᱶᯕ⦥᫵⦹ʑভྙᨱŖᱶĥ⫮ᙹพ݉ĥᨱᕽ⬉ᮉᱢᯕ ḡ༜⦹݅. Ŗᱶĥ⫮ᮥ᭥⧕⦥᫵⦽ᱶᅕ۵1ᯝᔾᔑᖒᱶᅕᯕ໑, ᯕভ᯲ᨦᨱ⦥᫵⦽ᰆእ, ᯱᰍ, ᯙಆᨱݡ⦽ᙹపᱶᅕᯕ݅. 1ᯝ᯲ᨦᨱ

ᗭ᫵ࡹ۵ ᰆእ, ᯱᰍ ᯙಆᮥ ə൚⪵ ⦹ᩍ ‘᯲ᨦ᳑’௝Ł ⦽݅.

⢽ᵡ⣩ᖩᮥ☖⧕ᰆእ᮹᯲ᨦపᮥᔑ⇽⦹۵ŝᱶᮡbbᰆእᨱ

ݡ⦽᯲ᨦపᔑ⇽Ŗ᜾ᮥ☖⧕ᯕ൉ᨕḥ݅. ᔑ⇽ࡽ᯲ᨦపᮥᯕᬊ⦹

ᩍ⚍᯦ᰆእ᮹ᙹపᮥᱶ⦹ŁŖᔍእෝđᱶ⦽݅. ᯕ᪡zᯕᰆእᄥ

᯲ᨦపŖ᜾ᮥ☖⧕᯲ᨦపᮥᔑ⇽⦹۵ႊჶᮡ᯲ᨦ᳑Õᨱ঑௝

đᱶࡹ۵ ᄡᙹॅᮥ ݡ᯦⦹ᩍ ĥᔑ⦽݅. ᯕ᪡ zᯕ Ŗ᜾ᮥ ☖⧕

ᰆእ᮹᯲ᨦపᮥᔑ⇽⦹۵ႊ᜾ᮡᰆእ᮹Ƚ༉ӹ, ⩥ᰆ᳑ᔍ᮹ᇡᱶ

⪶ᖒᨱ঑ෙ☁ḩ᮹ᄡ⪵, ᯲ᨦᩍÕ᮹ӽᯕ॒ࠥฯᮡᇩ⪶ᝅᖒᯕ

᳕ᰍ⦹۵ߑฯᮡ᳑Õॅᵲᨱ⦹ӹ௝ࠥᄡ⦽݅໕ၹᅖᱢᯙĥᔑ

᯲ᨦᯕ᫵Ǎࡽ݅. ✚⯩, ᅙᩑǍ᮹ჵ᭥ಽᖅᱶ⦽⦹⃽Ŗᔍ᮹Ğᬑ

ྜྷᯕ Ŗᔍᨱ ᩩ⊂⦹ʑ ᨕಅᬕ ᩢ⨆ᮥ ၙ⊹ʑ ভྙᨱ ᮂᔢᨱᕽ

ᯕ൉ᨕḡ۵᯲ᨦᅕ݅ฯᮡᇩ⪶ᝅᖒᮥaḡŁᯩ݅. ᯝᅙ⢽ᵡᅕŹ ᮹Ğᬑᰆእ᯲ᨦపᮡᰆእᄥ, ȽĊᄥ, ᯲ᨦ᳑Õᄥಽ᯲ᨦపᮥ

⢽ෝ ☖⧕ ᱽ᜽⦹Ł ᯩ݅. ʑ᳕ᨱ ᙹ⧪ࡹᨩ޹ 100ᩍÕ ᯕᔢ᮹

ᔍಡෝ ☖⧕ ᰆእ᮹ ᯝၹᱢ ᔾᔑᖒ ᱶᅕෝ ᔑᱶ⦹ᩍ ᱽ᜽⦽݅.

঑௝ᕽ, ᯝᅙ ⢽ᵡᅕŹ᮹ Ğᬑ ᰆእ, ȽĊ, ᳑Õᨱ ঑௝ ᄥࠥ᮹

ĥᔑŝᱶ ᨧᯕ ⢽ᨱᕽ ᰆእ᮹ 1ᯝ ᯲ᨦపᱶᅕෝ ᨜ᮥ ᙹ ᯩ݅.

ᅙᩑǍ᮹༊ᱢᮡ⦹⃽Ŗᔍ᮹Ŗᔍᯝᱶᮥᙹพ⦹Ł, ᰆእ⚍᯦ĥ

⫮ᮥᖙᬑ۵ŝᱶᨱᕽ⢽ᵡ⣩ᖩ᮹ᱢᬊᖒᮥ᷾ݡ᜽┅Łᯱ᯲ᨦ᳑

ၰ 1ᯝ ᔾᔑᖒ ᱶᅕෝ ᔑ⇽⦹Łᯱ ⦽݅.

1.2 ઴࣐֜଍ࢫࢺ࣑

ᅙᩑǍ۵⦹⃽Ŗᔍ᮹ݡ⢽Ŗ᳦ᮥݡᔢᮝಽḥ⧪⦹ᩡᮝ໑, ݡ⢽

Ŗ᳦ᮥ ᖁᱶ⦹۵ ŝᱶᮡ ⅾ 2݉ĥಽ ḥ⧪ࡹᨩ݅. 1݉ĥಽ 5Õ

81}ᱽႊᄥᯱഭෝᙹḲ⦹ᩍḥ⧪⦹ᩡ݅. ᯕᵲ⦹⃽ᅖᬱᔍᨦᯕ

70%, ᔾ┽⦹⃽᳑ᖒᔍᨦᯕ22%, ⦹⃽}ᙹᔍᨦᯕ8%ෝ₉ḡ⦹ᩡ

ᮝ໑, ᙹḲࡽᯱഭॅᮡ67%a2007֥ᯕ⬥ᨱᖅĥࡽᯱഭಽ2007

֥ᯕ⬥ᯱᩑ⩶⦹⃽Ŗᔍa⪽ၽ⯩ḥ⧪ࡹᨩᮭᮥ᦭ᙹᯩ݅. ᙹḲࡽ

ᯱഭᨱᕽኩࠥᙹa׳ᮡŖ᳦ᮥᖁᱶ⦹ŁŖᔍእእᵲᯕⓑŖ᳦ᮥ

ᵲᝍᮝಽ Ǎᖒ⦹ᩡ݅.

2݉ĥ۵⦹⃽Ŗᔍᱥྙa᪡໕ݕᮥ☖⧕ḥ⧪ࡹᨩ݅. 1݉ĥෝ

☖⧕ᖁᱶࡽŖ᳦᮹┡ݚᖒá☁, bŖ᳦᮹ᨦྕჵ᭥ᱶ᮹, Ŗᔍእ ᮹እᵲᮡ᯲ḡอᵲ᫵ࠥa׳ᮡŖ᳦᮹⇵a, ⪙ᦩŖ᮹ᇥඹʑᵡ

॒ᨱݡ⦽ԕᬊᮥၹᩢ⦹ᩡ݅. əđŝݡŖ᳦ᮡ⇶ᱽŖ, ⪙ᦩŖ, Ǎ᳑ྜྷŖ, ᇡݡŖ4}ಽǍᇥ⦹ᩡᮝ໑, ⇶ᱽŖ10}, ⪙ᦩŖ4}, Ǎ᳑ྜྷŖ10}, ᇡݡŖ4}, ⅾ28}᮹ᖙᇡŖ᳦ᮥᖁᱶ⦹ᩡᮝ໑

ᖙᇡŖ᳦ŝݡ⢽Ŗ᳦ᮥzᮡ᮹ၙಽᅕᦹ݅. 2݉ĥ᮹Ğᬑɩvḡ ᩎ⦹⃽Ŗᔍ᮹ᝅྕᯱಽⅾ6⫭᮹໕ݕᮥḥ⧪⦹ᩡᮝ໑, bŖ᳦᮹

✚ᖒၰᯝၹᱢ᯲ᨦ᳑Õ᮹ᖅᱶᨱݡ⦽ԕᬊᮥ⡍⧉⦹ᩍḥ⧪⦹ᩡ݅.

Table 1᮹ݡ⢽Ŗ᳦ᮥݡᔢᮝಽᩑǍෝḥ⧪⦹ᩡᮝ໑᯲ᨦ᳑

Ǎᖒၰ1ᯝᔾᔑᖒᱶᅕᨱݡ⦽ᙹ⊹۵⢽ᵡ⣩ᖩŝ⦹⃽ᖅĥᝅྕ᫵

ಚᮥၵ┶ᮝಽᔑ⇽⦹ᩡ݅. ᯲ᨦ᳑Õ᮹ᖅᱶᮡ⩥ᰍᖅĥ⫭ᔍᨱ

ᰍḢᵲᯙᱥྙa᪡2⫭໕ݕᮥ☖⧕⦹⃽ᖅĥᝅྕ᫵ಚᯕaᰆ

ᯝၹᱢᯙ᳑Õᮥᱽ᜽⦽݅Ł❱݉⦹ᩍ⦹⃽Ŗᔍᖅĥᝅྕ᫵ಚ᮹

᯲ᨦ᳑Õᮥ ၵ┶ᮝಽ ᖅᱶ⦹ᩡ݅.

ᰆእ᮹᯲ᨦపᔑ⇽ŝᱶ᮹eᗭ⪵ෝ᭥⦽ᩑǍ۵⦹⃽Ŗᔍݡ⢽

Ŗ᳦ᨱᕽᯕᬊࡹ۵ᰆእෝჵ᭥ಽᱶ⦹ᩡ݅. ᯝᅙ᮹⢽ᵡᅕŹ᪡

zᮡ ⩶᜾ᮝಽ ʑĥ᮹ ᯲ᨦపᮥ ᰆእ᮹ ȽĊŝ ӽᯕࠥෝ ⢽ಽ

ᱽ᜽⦹ᩡᮝ໑, ᯲ᨦపᔑ⇽Ŗ᜾ၰ᯲ᨦ᳑Õᮡ⢽ᵡ⣩ᖩŝ⦹⃽Ŗ ᔍᖅĥᝅྕ᫵ಚᮥ☖⧕ᔑ⇽⦹ᩡ݅. ᰆእ᮹᯲ᨦపᮥǍ⦹ᩍ᯲ᨦ

᳑ᨱ⡍⧉᜽⍽Ǎᖒ⦹ᩡᮝ໑, ࠺ᯝ⦽ᰆእ᮹Ğᬑ᯲ᨦ᳑Õᮥz݅

Ł aᱶ⦹ᩍ ᯲ᨦపᮥ ᔑ⇽⦹ᩡ݅.

2. ᅙು

2.1 ࢠ֝րଵ࣭ଭୡॺࢂෝ୺ॷ 2.1.1 ࢠ֝ଭRs Means

ၙǎᱢᔑྙ⨭ᯙRS Means᮹Ğᬑݡ⢽ᱢᯙ᯲ᨦ᳑Ǎᖒ⩶᜾

᮹ᱢᔑྙ⨭ᯕ݅. ၙǎRS Means᮹᯲ᨦ᳑ၰᔾᔑᖒᱶᅕǍ᳑۵

݅ᮭŝ z݅.

(3)

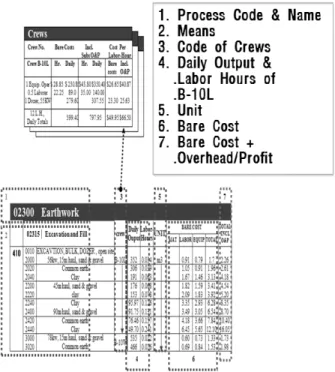

Fig. 1. Rs Means Structure in America

Apply Unit (Scope)

 Construction Outline

 Method Select

 Standard of Estimate

Fig. 3. Estimate Process of Japanese Standard Labor Counting

Table 2. Backhoe Workload of Japanese Standard Labor Counting Work

type Standard Soil Type Unit Output

Non-Stinger Stinger

Ground Soil

Banking 0.8  (Stacking flat 0.6)

Stony Sand, Sand, Sandy soil, Cohesive soil

m

3

300 190

Rock block Tin " 230 140 Banking

1.4  (Stacking flat 1.0 )

Stony Sand, Sand, Sandy soil, Cohesive soil

" 500 320

Rock block Tin " 410 260

Lose Soil

Banking 0.8

(Stacking flat 0.6 )

Stony Sand, Sand, Sandy soil, Cohesive soil

" 310

Rock block Tin " 260 Banking

1.4  (Stacking flat 1.0 )

Stony Sand, Sand, Sandy soil, Cohesive soil

" 520

Rock block Tin " 440 Banking0.4

5  (Stacking flat 0.35 )

Stony Sand, Sand, Sandy soil, Cohesive soil

" 160

Rock block Tin " 130

Excava tion

Banking 0.8

(Stacking flat 0.6)

Stony Sand, Sand, Sandy soil, Cohesive soil

" 220 180

Rock block Tin " 160 130 Banking0.4

5  (Stacking flat 0.35 )

Stony Sand, Sand, Sandy soil, Cohesive soil

" 150 100

Rock block Tin " 110 70

ၙǎ᮹Rs Meansෝ⪽ᬊ⦹ᩍŖᔍእෝᔑ⇽⦹۵ႊჶᮡ⧕ݚ

Ŗ᳦᮹⎵ऽෝ₟ᦥ᯲ᨦ᳑Õᨱ฿۵᯲ᨦ᳑ෝᖁ┾⦹۵ႊ᜾ᯕ݅.

⧕ݚ᯲ᨦ᳑ᨱ۵1ᯝᔾᔑᖒᱶᅕaᱽ᜽ࡹʑভྙᨱⅾ᯲ᨦపᮥ

ᯝᯝᔾᔑᖒᮝಽӹ٩sᮥ⧕ݚ᯲ᨦ᳑᮹݉᭥እᬊᮥŒ⦹໕ⅾ

Ŗᔍእෝ ᔑ⇽⧁ ᙹ ᯩ݅.

Fig. 2. Rs Means’s Work Crew-Combination in America

ၙǎ᮹ RS Means۵ zᮡ Ŗ᳦ᯕ௝ ⦹޵௝ࠥ Ŗᔍ᮹ Ƚ༉,

᯲ᨦᩍÕ ॒ᩍ్ ᳑Õᨱ ঑௝᯲ᨦ᳑ Ǎᖒᯕӹ ᔾᔑᖒᨱݡ⦽

ᱶᅕa݅᧲⦹ʑভྙᨱ⩥ᝅᱢᯕ௝Ł⧁ᙹᯩ݅. ə్ʑ᭥⧕ᕽ۵

ᝅᱽŖᔍ᮹ᝅ⊂sᮥၵ┶ᮝಽḡᗮᱢᯙᱶᅕ᮹⦝ऽ႒ŝᱶᯕ

ၹऽ᜽ ⦥᫵⦹݅.

2.1.2 ଵ࣭ଭඝஜ࣪։

ᯝᅙ᮹ݡ⢽ᱢᔑྙ⨭ᯙ⢽ᵡᅕŹ۵ŝÑ⦽ǎ᮹⢽ᵡ⣩ᖩᮥ

Ǎᖒ⦹ʑ᭥⦽ʑⅩᯱഭಽᔍᬊࡹᨩʑভྙᨱᮁᔍ⦽ᇡᇥᯕฯᯕ

ᯩ݅. ⢽ᵡᅕŹෝ☖⦽ᱢᔑŝᱶᮥᔕ⠕ᅕ໕݅ᮭTable 2᪡z݅.

⦽ǎ᮹⢽ᵡ⣩ᖩŝᯝᅙ᮹⢽ᵡᅕŹ᮹aᰆⓑ₉ᯕᱱᮡᰆእ᮹

᯲ᨦపᔑ⇽ŝᱶᯕ݅. ǎԕ᮹⢽ᵡ⣩ᖩᨱᕽ۵ᰆእᨱ঑ෙ᯲ᨦప

(4)

Table 3. Existing Standard of Estimate

Cutting Ground Grading (Per 10 )

Soil Type

Division Normal

Laborer (Person)

Air Com (Hr)

Compact Breaker

(Hr)

Backhoe (Hr) Sand, Sandy Soil, Clay,

Cohesive Soil 0.05 - - 0.15

Brittle storn, Screeings 0.08 - - 0.21

Coagulating Soil with

Cobble Stone 0.1 - - 0.24

Weathered Rock 0.19 - - 0.45

Soft Rock 0.46 1.25 2.45 -

Normal Rock, Hard

Rock 0.61 1.55 3.05 -

Table 4. Estimate of Work Crew-Combination

Cutting Ground Grading (per Day)

Soil Type

Division

Output Normal ()

Laborer (Person)

Air Com (Hr)

Compact Breaker

(Hr)

Backhoe (Hr) Sand, Sandy Soil, Clay,

Cohesive Soil 3 - - 1 533.33

Brittle storn, Screeings 4 - - 1 380.10

Coagulating Soil with

Cobble Stone 4 - - 1 333.33

Weathered Rock 4 - - 1 177.80

Soft Rock 2 2 1 - 32.7

Normal Rock, Hard

Rock 2 2 1 - 26.2

ᔑᱶ᜾ᮥ☖⧕ᰆእ᮹᯲ᨦపᮥᩩ⊂⧁ᙹᯩḡอᯝᅙ⢽ᵡᅕŹ᮹

Ğᬑᰆእ᮹᯲ᨦపᮥ⢽ෝ☖⧕᳑Õᨱ঑௝ᱽ᜽⦹ʑভྙᯕ݅.

Table 2᪡zᯕ⢽ෝ☖⧕ ᰆእ᮹᯲ᨦపᮥᱽ᜽⦹۵ႊჶᮡ

⦽ǎ᮹⢽ᵡ⣩ᖩ᮹᯲ᨦపᔑ⇽Ŗ᜾ᮥ☖⦽᯲ᨦపᔑ⇽ႊჶᅕ݅

⭉ᦍᛍᬕŝᱶᮥ☖⧕᯲ᨦపᮥᔑ⇽⧁ᙹᯩ݅. ྜྷುᯝၹᱢᯙ

ᰆእ᮹᯲ᨦపᮥᔑ⇽⦹ʑ᭥⧕ᕽ۵ฯᮡᔍಡ᮹᜽ŖᔍಡෝᙹḲ

⧕᧝⦹ʑভྙᨱᱶᅕᙹḲŝᯝၹ⪵ŝᱶᨱᕽฯᮡ᜽eŝיಆᮥ

⦥᫵ಽ ⦽݅.

2.2 ୁડ୺֜নࢫୋणୁડ߆ॺౢր୨ 2.2.1 ୁડ୺֜ন

ǎԕ⢽ᵡ⣩ᖩ᮹⩶᜾ᮡ݅ᮭTable 3ŝz݅. 10⽊᮹ᱩ☁໕ᮥ

Ł෕ʑ᭥⦽ᯙಆŝᰆእෝӹ┡ԕŁᯩ۵ߑ, ᖅĥࡽྜྷపᨱ⦥᫵⦽

ᰍᬱᮥ Ǎ⦹ʑ ᭥⦽ Ǎ᳑ಽ ᅝ ᙹ ᯩ݅.

Table 3ŝ zᮡʑ᳕⢽ᵡ⣩ᖩ⩶᜾ᮥ☖⧕ᔍḩ☁ 60,000⽎᮹

ᱩ☁໕ Ł෕ʑ ᯲ᨦ᮹ ᱢᔑŝᱶᮥ ᩩ᜽ಽ ॅ໕ ݅ᮭŝ z݅.

1) 1ᯝ ⚍᯦ᨱ aᰆ ᵲ᫵⦽ ⧎༊ᮥ ʑᵡᮝಽ ĥᔑ⦽݅.

ᷪ, ᔍḩ☁ ᅕ☖ᯙᇡ: 60,000⽎/10⽎ × 0.05ᯙ = 300໦

2) ⚍᯦ ᰆእ᮹ ᯲ᨦ ᜽eᮥ ᔑ⇽⦽݅.

ᷪ, ႒⪙: 60,000⽎/10⽎ × 0.15ݡ = 900᜽e 3) 1ᯝ 8᜽e ʑᵡᮝಽ ⦥᫵ ᰆእ ݡᙹ ᔑᱶ

ᷪ, 900᜽e / 8᜽e = 113ݡ

ʑ᳕᮹⢽ᵡ⣩ᖩ⩶᜾ᮡ݉aᔑ⇽ᮥ᭥⦽Ǎ᳑ಽᗭ᫵ࡹ۵ᰍᬱ ᨱ݉aෝŒ⦹ᩍŖᔍእෝᔑᱶ⧁ᙹᯩ۵ႊჶᯕ݅. ə్ӹᯕ్⦽

⩶᜾ᮡ60,000⽎᮹ᱩ☁໕Ł෕ʑᨱ⦥᫵⦽Ŗʑෝ᦭ᙹᨧ݅.

Ŗᱶĥ⫮ᮥᙹพ⦹۵ŝᱶᨱᕽ۵݅ᮭŖᱶŝ᮹ᩑĥᖒᮥ❭ᦦ⧕

᧝ ⦹Ł ᰍᬱॅ᮹ ⚍᯦᜽ʑෝ ᩩ⊂⧕᧝ ⦹ʑ ভྙᨱ Ŗᱶšญ

݉ĥᨱᕽ ᱢᬊ⦹ʑ ᭥⦽ ᱶᅕa ∊ᇥ⦹ḡ ᦫ݅.

ᅙᩑǍෝ☖⧕Ǎᖒ⦹Łᯱ⦹۵⣩ᖩ⩶᜾ᮡʑ᳕᮹⣩ᖩᨱᕽ

ᱽŖ⧕ᵝḡ༜⦽1ᯝ᯲ᨦపᨱݡ⦽ᱶᅕෝᱽ᜽⦹Łᗭ᫵ࡹ۵

ᰍᬱॅᮥᱶᙹಽᱽ᜽⦹۵äᯕ݅. 1ᯝ᯲ᨦపᮥၵ┶ᮝಽᱥℕ

ྜྷపᨱ঑ෙŖᱶĥ⫮ᙹพŝᱶᯕeᗭ⪵ࢁäᯕ໑, ᗭ᫵ᰍᬱॅ᮹

ᇥ႑ĥ⫮ᨱࠥ⭉ᦍᮁญ⦽⩶᜾ᯕ݅. ⦥᫵ᰍᬱॅᮥᱶᙹಽ⢽⩥⦹

۵äᮡᯝ(㘇)݉᭥ಽŖᱶᮥᙹพ⦹ʑভྙᨱᝅᱽ᯲ᨦᨱ⚍᯦ࡹ

ᨕ᧝⦹۵ᰍᬱᮥ⢽⩥⦹ʑ᭥⧉ᯕ݅. ⇶ᱽŖ᮹ᱩ☁໕Ł෕ʑ᮹

Ŗ᳦᮹ Ğᬑ ݅ᮭ Table 4᪡ zᯕ ⢽⩥⧁ ᙹ ᯩ݅.

Table 4᪡ zᯕ ᯲ᨦ᳑ ၰ ᔾᔑᖒ ᵲᝍᮝಽ Ǎᖒࡽ ⣩ᖩ᮹

⩶᜾ᮥ☖⧕ᔍḩ☁60,000⽎᮹ᱩ☁໕Ł෕ʑ᯲ᨦ᮹ᱢᔑŝᱶᮥ

ᩩಽ ॅ໕ ݅ᮭŝ z݅.

1) ⅾ ᯲ᨦᯝᙹ = 60,000 / 533.33 = 112.5 ᯝ (113ᯝ) 2) ᗭ᫵ᰍᬱ

- ᅕ☖ᯙᇡ : 3 x 113=339໦

- ႒⪙ : 113ݡ

3) እᬊ : ᗭ᫵ ᯱᬱ × ݉a

ⅾྜྷపᯕđᱶࡹᨩᮥভ⦥᫵⦽Ŗʑෝᩩ⊂⦹ʑᛞŁ, ᗭ᫵

ᰍᬱॅᮥ⦽٩ᨱ❭ᦦ⧁ᙹᯩʑভྙᨱŖᱶĥ⫮݉ĥᨱᕽᱢᬊ᜽

┅ʑᨱ ʑ᳕᮹ ⢽ᵡ⣩ᖩᅕ݅ ᮁญ⦽ ⩶᜾ᯕ௝Ł ⧁ ᙹ ᯩ݅.

2.2.2 ୋणଭୁડ߆ॺౢր୨

⢽ᵡ⣩ᖩᮡ᯲ᨦపᔑᱶ᜾ᮥ☖⧕ʑĥ᮹᯲ᨦపᮥᔑ⇽⦹۵

ႊ᜾ᯕ݅. ᖵትĥǕᔎʑ᮹᯲ᨦపᔑ⇽ŝᱶᮥᔕ⠕ᅕ໕ʑĥ᮹

Ƚ༉, ᯲ᨦ⬉ᮉ, ℕᱢ⪹ᔑĥᙹ, ᔍᯕⓕ┡ᯥ॒ᰆእ᮹ȽĊᯕӹ

᯲ᨦ ᳑Õᨱ ঑ෙ ᄡᙹෝ ݡ᯦⧕᧝ ⦽݅. อ᧞ ᯕॅ ᵲ 1aḡ

᳑Õᯕ௝ࠥ ᄡ⦽݅໕ ᯲ᨦప ᔑ⇽ŝᱶᮥ ၹᅖ⧕᧝ ⦽݅.

(5)

Table 5. Work Crew-Combination in Earthworks and Productivity Information

Work Type Division Work Crew Work Rate / Day

Building Ground Grading

Clay or Cohesive Soil Normal Laborer 1 Person 52.63 

Sand or Sandy Soil Sand or Sandy Soil 58.82 

Cutting Ground Grading

Sand, Sandy Soil, Clay, Cohesive Soil Normal Laborer 2.67 Persons 0.7GExcavator 1 533.33G Brittle storn, Screeings Normal Laborer 3.43 Persons 0.7 GExcavator 1 380.10  Coagulating Soil with Cobble Stone, Normal Laborer 3.33 Persons 0.7 GExcavator 1 333.33 G

Weathered Rock Normal Laborer 3.38 Persons 0.7 GExcavator 1 177.80 G Soft Rock Normal Laborer 1.50 Persons Compact Breaker 1 /min 1

3.5 /min Air Compressor 1.96 32.7 G

Normal Rock GHard Rock Normal Laborer 1.60 Persons Compact Breaker 1 /min 1

3.5 /min Air Compressor 1.97 26.2

Strip Sodding Normal Laborer 1 Person 22.22 

Block Sodding Normal Laborer 1 Person 16.67 

Straw Sodding Special Laborer 1 Person

Normal Laborer 1.53 Persons 666.67 

Filling

Excavation Dozer 32ton 1 775.2

Dozer 19ton 1 462.4

Babking

Backhoe 1.0 G1 443.9

Backhoe 0.7 G1 310.75

Backhoe 0.4 G1 177.57

Transportation (Omit)

Spoil Banking Banking

Backhoe 1.0 G1 443.9

Backhoe 0.7 G1 310.75

Backhoe 0.4 G1 177.57

Transportation (Omit)

Soil Masonry

Grading Dozer 19ton 527.87

Laying Dozer 19ton 19.98

Sprinkling Water Sprinkler Truck 5,500L 699.19

Cut embankment

Excavation Dozer 32ton 1 775.2

Dozer 19ton 1 462.4

Banking

Backhoe 1.0G1 443.9

Backhoe 0.7 G1 310.75

Backhoe 0.4 G1 177.57

Transportation (Omit)

Slope Compaction Hydraulic Vibrating Compactor 69ton Hydraulic Backhoe 0.7 624.60

ª á ć ÐìÓ×× Z ƏZ ƉZ Ƅ Z ž œƋ

ª = ᜽eݚ ᯲ᨦప( Ƌ

Ð

îƆƐ ) Ƅ = ℕᱢ⪹ᔑĥᙹ Ɖ = ॵ⟝ ੱ۵ ⟝┘ĥᙹ Ə = ॵ⟝ੱ۵ ქ┘ᬊప( Ƌ

Ð

)

ž = ᯲ᨦ⬉ᮉ œ

Ƌ

= 1⫭ ᔍᯕⓕ᜽e(Ⅹ) Eq. (1) Construction Capability Equation of Shovel-Typed Excavator

2009 ÕᖅŖᔍ⢽ᵡ⣩ᖩ᮹ Ğᬑ46᳦ඹᰆእ᯲ᨦప ᔑᱶ᜾ŝ

᯲ᨦᩍÕᨱ঑ෙᄡᙹෝᱽ᜽⦹Łᯩᮝ໑, ᯲ᨦ᳑Õᨱ঑ෙ᳑Õᄡ ᙹෝ ⧉̹ ᱽ᜽⦹Ł ᯩ۵ ⩶᜾ᯕ݅.

ᯝᅙ ⢽ᵡᅕŹ᪡ እƱ⧩ᮥ ভ ᅕ݅ ⪶ᝅ⦽ ᯲ᨦపᮥ ᔑ⇽ ⧁

ᙹᯩᮥäᮝಽʑݡࡹḡอ, Ⅹʑ݉ĥᨱᕽ᮹Ŗᔍእᔑ⇽݉ĥӹŖᔍ

ĥ⫮ᮥᙹพ⦹۵݉ĥᨱᕽ}ఖᱢᯙ᯲ᨦపᮥ⦥᫵ಽ⦹۵݉ĥᨱᕽ

۵ ᰆእ᮹ ⠪Ɂᱢᯙ ᯲ᨦపᮥ ᱢᬊ᜽┅۵ ႊჶᯕ ᮁญ⧁ äᯕ݅.

(6)

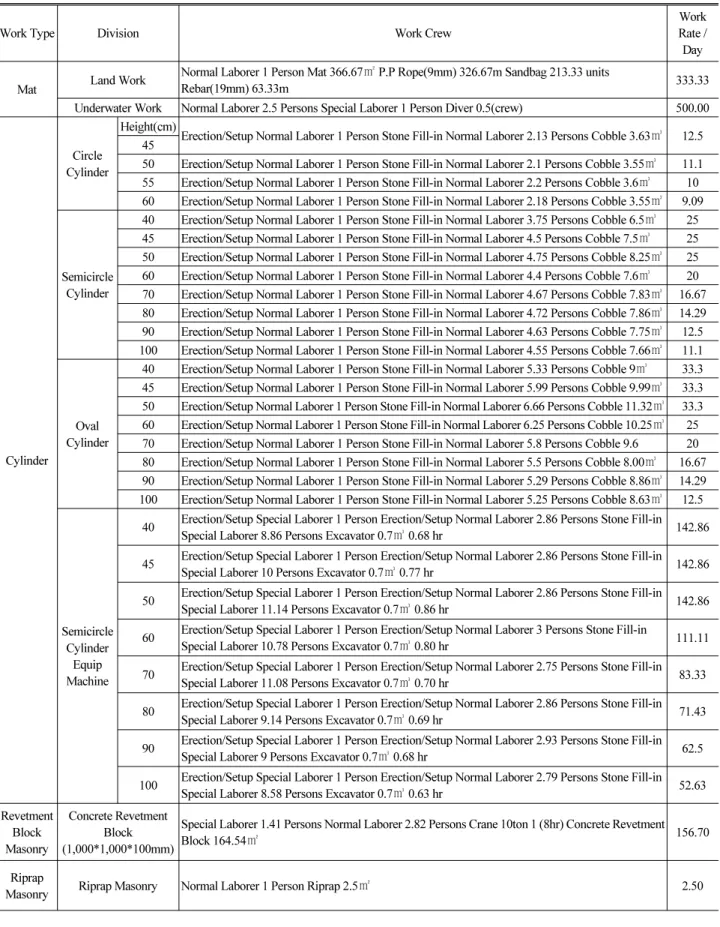

Table 6. Work Crew-Combination in Revetments and Productivity Information

Work Type Division Work Crew

Work Rate / Day

Mat Land Work Normal Laborer 1 Person Mat 366.67GP.P Rope(9mm) 326.67m Sandbag 213.33 units

Rebar(19mm) 63.33m 333.33

Underwater Work Normal Laborer 2.5 Persons Special Laborer 1 Person Diver 0.5(crew) 500.00

Cylinder

Circle Cylinder

Height(cm)

Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 2.13 Persons Cobble 3.63 12.5 45

50 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 2.1 Persons Cobble 3.55 11.1 55 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 2.2 Persons Cobble 3.6  10 60 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 2.18 Persons Cobble 3.55  9.09

Semicircle Cylinder

40 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 3.75 Persons Cobble 6.5  25 45 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.5 Persons Cobble 7.5  25 50 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.75 Persons Cobble 8.25  25 60 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.4 Persons Cobble 7.6  20 70 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.67 Persons Cobble 7.83  16.67 80 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.72 Persons Cobble 7.86 14.29 90 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.63 Persons Cobble 7.75  12.5 100 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 4.55 Persons Cobble 7.66  11.1

Oval Cylinder

40 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.33 Persons Cobble 9 33.3 45 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.99 Persons Cobble 9.99  33.3 50 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 6.66 Persons Cobble 11.32  33.3 60 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 6.25 Persons Cobble 10.25 25 70 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.8 Persons Cobble 9.6 20 80 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.5 Persons Cobble 8.00  16.67 90 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.29 Persons Cobble 8.86  14.29 100 Erection/Setup Normal Laborer 1 Person Stone Fill-in Normal Laborer 5.25 Persons Cobble 8.63  12.5

Semicircle Cylinder

Equip Machine

40 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.86 Persons Stone Fill-in

Special Laborer 8.86 Persons Excavator 0.7 G0.68 hr 142.86

45 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.86 Persons Stone Fill-in

Special Laborer 10 Persons Excavator 0.7 G0.77 hr 142.86

50 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.86 Persons Stone Fill-in

Special Laborer 11.14 Persons Excavator 0.7 G0.86 hr 142.86

60 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 3 Persons Stone Fill-in

Special Laborer 10.78 Persons Excavator 0.7 G0.80 hr 111.11

70 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.75 Persons Stone Fill-in

Special Laborer 11.08 Persons Excavator 0.7G0.70 hr 83.33

80 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.86 Persons Stone Fill-in

Special Laborer 9.14 Persons Excavator 0.7G0.69 hr 71.43

90 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.93 Persons Stone Fill-in

Special Laborer 9 Persons Excavator 0.7 G0.68 hr 62.5

100 Erection/Setup Special Laborer 1 Person Erection/Setup Normal Laborer 2.79 Persons Stone Fill-in

Special Laborer 8.58 Persons Excavator 0.7 G0.63 hr 52.63

Revetment Block Masonry

Concrete Revetment Block (1,000*1,000*100mm)

Special Laborer 1.41 Persons Normal Laborer 2.82 Persons Crane 10ton 1 (8hr) Concrete Revetment

Block 164.54  156.70

Riprap

Masonry Riprap Masonry Normal Laborer 1 Person Riprap 2.5 2.50

(7)

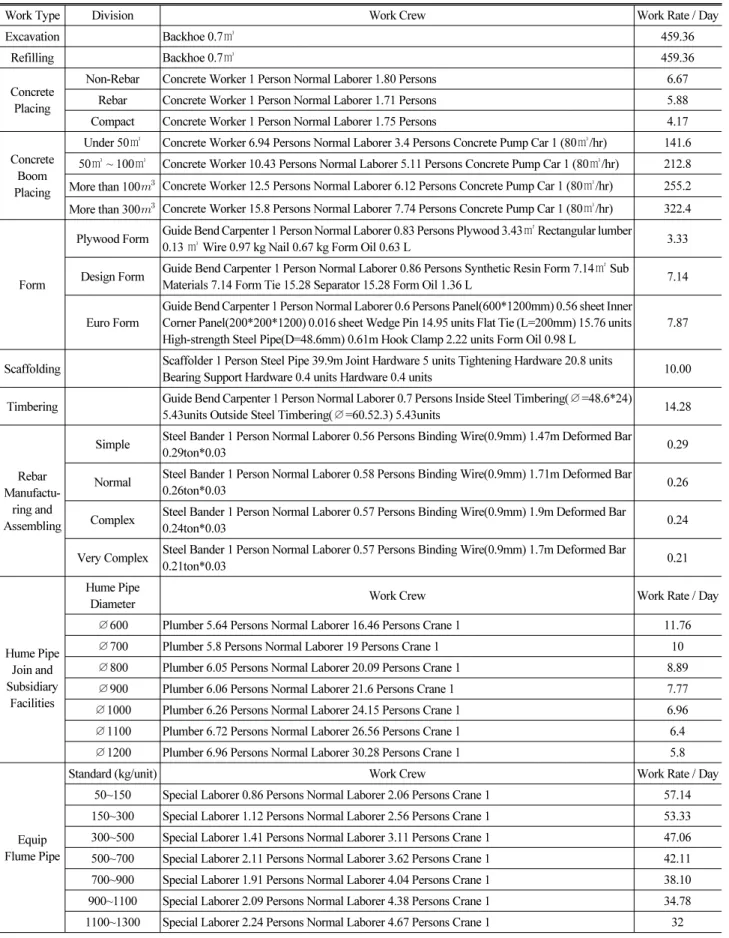

Table 7. Work Crew-Combination in Structures Process and Productivity Information (continued)

Work Type Division Work Crew Work Rate / Day

Excavation Backhoe 0.7 459.36

Refilling Backhoe 0.7  459.36

Concrete Placing

Non-Rebar Concrete Worker 1 Person Normal Laborer 1.80 Persons 6.67

Rebar Concrete Worker 1 Person Normal Laborer 1.71 Persons 5.88

Compact Concrete Worker 1 Person Normal Laborer 1.75 Persons 4.17

Concrete Boom Placing

Under 50  Concrete Worker 6.94 Persons Normal Laborer 3.4 Persons Concrete Pump Car 1 (80 /hr) 141.6 50 G~ 100 Concrete Worker 10.43 Persons Normal Laborer 5.11 Persons Concrete Pump Car 1 (80/hr) 212.8 More than 100

ƋÐ

Concrete Worker 12.5 Persons Normal Laborer 6.12 Persons Concrete Pump Car 1 (80 /hr) 255.2 More than 300

ƋÐ

Concrete Worker 15.8 Persons Normal Laborer 7.74 Persons Concrete Pump Car 1 (80 /hr) 322.4

Form

Plywood Form Guide Bend Carpenter 1 Person Normal Laborer 0.83 Persons Plywood 3.43 GRectangular lumber

0.13 GWire 0.97 kg Nail 0.67 kg Form Oil 0.63 L 3.33

Design Form Guide Bend Carpenter 1 Person Normal Laborer 0.86 Persons Synthetic Resin Form 7.14GSub

Materials 7.14 Form Tie 15.28 Separator 15.28 Form Oil 1.36 L 7.14

Euro Form

Guide Bend Carpenter 1 Person Normal Laborer 0.6 Persons Panel(600*1200mm) 0.56 sheet Inner Corner Panel(200*200*1200) 0.016 sheet Wedge Pin 14.95 units Flat Tie (L=200mm) 15.76 units High-strength Steel Pipe(D=48.6mm) 0.61m Hook Clamp 2.22 units Form Oil 0.98 L

7.87

Scaffolding Scaffolder 1 Person Steel Pipe 39.9m Joint Hardware 5 units Tightening Hardware 20.8 units

Bearing Support Hardware 0.4 units Hardware 0.4 units 10.00

Timbering Guide Bend Carpenter 1 Person Normal Laborer 0.7 Persons Inside Steel Timbering(=48.6*24)

5.43units Outside Steel Timbering( =60.52.3) 5.43units 14.28

Rebar Manufactu-

ring and Assembling

Simple Steel Bander 1 Person Normal Laborer 0.56 Persons Binding Wire(0.9mm) 1.47m Deformed Bar

0.29ton*0.03 0.29

Normal Steel Bander 1 Person Normal Laborer 0.58 Persons Binding Wire(0.9mm) 1.71m Deformed Bar

0.26ton*0.03 0.26

Complex Steel Bander 1 Person Normal Laborer 0.57 Persons Binding Wire(0.9mm) 1.9m Deformed Bar

0.24ton*0.03 0.24

Very Complex Steel Bander 1 Person Normal Laborer 0.57 Persons Binding Wire(0.9mm) 1.7m Deformed Bar

0.21ton*0.03 0.21

Hume Pipe Join and Subsidiary

Facilities

Hume Pipe

Diameter Work Crew Work Rate / Day

600 Plumber 5.64 Persons Normal Laborer 16.46 Persons Crane 1 11.76

700 Plumber 5.8 Persons Normal Laborer 19 Persons Crane 1 10

800 Plumber 6.05 Persons Normal Laborer 20.09 Persons Crane 1 8.89

900 Plumber 6.06 Persons Normal Laborer 21.6 Persons Crane 1 7.77

1000 Plumber 6.26 Persons Normal Laborer 24.15 Persons Crane 1 6.96

1100 Plumber 6.72 Persons Normal Laborer 26.56 Persons Crane 1 6.4

1200 Plumber 6.96 Persons Normal Laborer 30.28 Persons Crane 1 5.8

Equip Flume Pipe

Standard (kg/unit) Work Crew Work Rate / Day

50~150 Special Laborer 0.86 Persons Normal Laborer 2.06 Persons Crane 1 57.14

150~300 Special Laborer 1.12 Persons Normal Laborer 2.56 Persons Crane 1 53.33

300~500 Special Laborer 1.41 Persons Normal Laborer 3.11 Persons Crane 1 47.06

500~700 Special Laborer 2.11 Persons Normal Laborer 3.62 Persons Crane 1 42.11

700~900 Special Laborer 1.91 Persons Normal Laborer 4.04 Persons Crane 1 38.10

900~1100 Special Laborer 2.09 Persons Normal Laborer 4.38 Persons Crane 1 34.78

1100~1300 Special Laborer 2.24 Persons Normal Laborer 4.67 Persons Crane 1 32

(8)

Table 7. Work Crew-Combination in Structures Process and Productivity Information

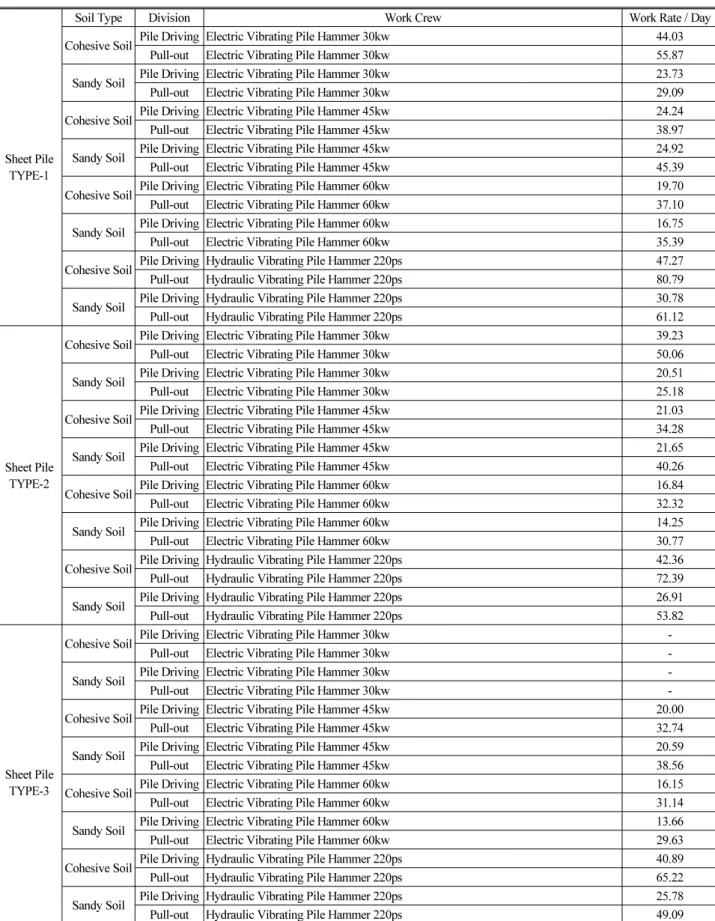

Sheet Pile TYPE-1

Soil Type Division Work Crew Work Rate / Day

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 30kw 44.03

Pull-out Electric Vibrating Pile Hammer 30kw 55.87

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 30kw 23.73

Pull-out Electric Vibrating Pile Hammer 30kw 29.09

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 45kw 24.24

Pull-out Electric Vibrating Pile Hammer 45kw 38.97

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 45kw 24.92

Pull-out Electric Vibrating Pile Hammer 45kw 45.39

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 60kw 19.70

Pull-out Electric Vibrating Pile Hammer 60kw 37.10

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 60kw 16.75

Pull-out Electric Vibrating Pile Hammer 60kw 35.39

Cohesive Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 47.27

Pull-out Hydraulic Vibrating Pile Hammer 220ps 80.79

Sandy Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 30.78

Pull-out Hydraulic Vibrating Pile Hammer 220ps 61.12

Sheet Pile TYPE-2

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 30kw 39.23

Pull-out Electric Vibrating Pile Hammer 30kw 50.06

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 30kw 20.51

Pull-out Electric Vibrating Pile Hammer 30kw 25.18

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 45kw 21.03

Pull-out Electric Vibrating Pile Hammer 45kw 34.28

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 45kw 21.65

Pull-out Electric Vibrating Pile Hammer 45kw 40.26

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 60kw 16.84

Pull-out Electric Vibrating Pile Hammer 60kw 32.32

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 60kw 14.25

Pull-out Electric Vibrating Pile Hammer 60kw 30.77

Cohesive Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 42.36

Pull-out Hydraulic Vibrating Pile Hammer 220ps 72.39

Sandy Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 26.91

Pull-out Hydraulic Vibrating Pile Hammer 220ps 53.82

Sheet Pile TYPE-3

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 30kw -

Pull-out Electric Vibrating Pile Hammer 30kw -

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 30kw -

Pull-out Electric Vibrating Pile Hammer 30kw -

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 45kw 20.00

Pull-out Electric Vibrating Pile Hammer 45kw 32.74

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 45kw 20.59

Pull-out Electric Vibrating Pile Hammer 45kw 38.56

Cohesive Soil Pile Driving Electric Vibrating Pile Hammer 60kw 16.15

Pull-out Electric Vibrating Pile Hammer 60kw 31.14

Sandy Soil Pile Driving Electric Vibrating Pile Hammer 60kw 13.66

Pull-out Electric Vibrating Pile Hammer 60kw 29.63

Cohesive Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 40.89

Pull-out Hydraulic Vibrating Pile Hammer 220ps 65.22

Sandy Soil Pile Driving Hydraulic Vibrating Pile Hammer 220ps 25.78

Pull-out Hydraulic Vibrating Pile Hammer 220ps 49.09

(9)

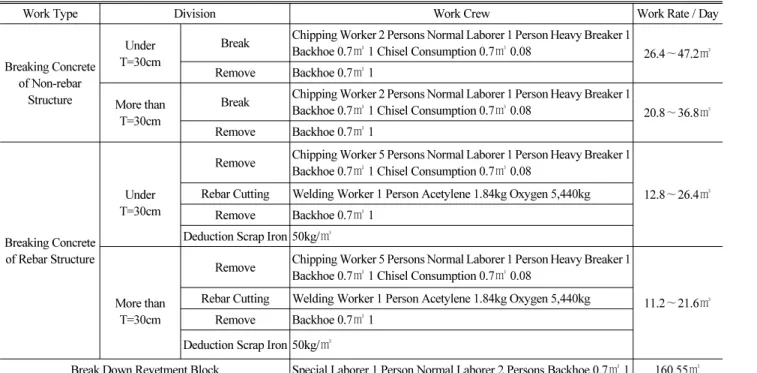

Table 8. Work Crew-Combination in Subsidiary Work and Productivity Information

Work Type Division Work Crew Work Rate / Day

Breaking Concrete of Non-rebar

Structure

Under T=30cm

Break Chipping Worker 2 Persons Normal Laborer 1 Person Heavy Breaker 1

Backhoe 0.7 G1 Chisel Consumption 0.7G0.08 26.447.2

Remove Backhoe 0.7 G1 More than

T=30cm

Break Chipping Worker 2 Persons Normal Laborer 1 Person Heavy Breaker 1

Backhoe 0.7 G1 Chisel Consumption 0.7G0.08 20.836.8

Remove Backhoe 0.7G1

Breaking Concrete of Rebar Structure

Under T=30cm

Remove Chipping Worker 5 Persons Normal Laborer 1 Person Heavy Breaker 1 Backhoe 0.7 G1 Chisel Consumption 0.7G0.08

12.8 26.4

Rebar Cutting Welding Worker 1 Person Acetylene 1.84kg Oxygen 5,440kg Remove Backhoe 0.7 G1

Deduction Scrap Iron 50kg/ 

More than T=30cm

Remove Chipping Worker 5 Persons Normal Laborer 1 Person Heavy Breaker 1 Backhoe 0.7 G1 Chisel Consumption 0.7G0.08

11.2 21.6

Rebar Cutting Welding Worker 1 Person Acetylene 1.84kg Oxygen 5,440kg Remove Backhoe 0.7 G1

Deduction Scrap Iron 50kg/

Break Down Revetment Block Special Laborer 1 Person Normal Laborer 2 Persons Backhoe 0.7G1 160.55

2.3 ෇వվॷ۩ඝվஂଭୁડ୺ඨম

2.3.1 ౠ୪վ

⇶ᱽŖᮡᯝၹᱢᮝಽ☁Ŗᯕ௝Ł⧁ᙹᯩ݅. ʑᅙ☁Ŗᔍᨱ

ᗮ⦹۵ᱩ☁໕Ł෕ʑ, ᖒ☁໕Ł෕ʑ, ᵥਝ, ⠪ਝ, Ñᱢਝ, ᙽᖒ☁, ᔍ☁, ⮺᝴ʑ, ᮁᬊᖒ☁, ჶ໕݅ḱᮥ⇶ᱽŖ᮹10}ᖙᇡŖ᳦ᮝಽ

Ǎᖒ⦹ᩡ݅. ☁Ŗ᮹Ğᬑ⦹⃽ᐱᦥܩ௝☁༊Ŗᔍ᮹ʑᅙᯕࡹ۵

Ŗ᳦ᯕအಽ⦹⃽Ŗᔍ᫙ᨱࠥb᳦☁༊Ŗᔍᨱᱢᬊᯕa܆⧁äᮝ ಽ ʑݡࡽ݅.

ᬕၹ᮹ĞᬑÑญᨱ঑௝ᕽᰆእ᮹᳑⧊ŝᔾᔑᖒᯕđᱶࡽ݅.

঑௝ᕽᬕၹÑญađᱶࡽᔢ⫊ᨱᕽᔾᔑᖒᮥᔑ⇽⧕᧝⦹ʑভྙ

ᨱ᭥᮹⢽ᨱᕽ۵ᔾఖ⦹ᩡ݅. ᯝᅙ᮹Ğᬑ႒⪙1ݡ, ߅⥥1ݡa

✚ᱶÑญෝᬕၹ⦹۵ߑÙญ۵᜽eᮥᯝ(㘇)݉᭥ಽ⢽⩥⦹ᩡ݅.

⣩ᖩᮥ☖⧕႒⪙1ݡ᪡߅⥥1ݡ᮹᳑⧊ᮝಽ᯲ᨦపᮥᔑ⇽ᦥᩡᮝ ӹᱥྙa᮹໕ݕŝᱶᨱᕽᰆእ᮹᳑⧊ŝÑญෝaᱶ⦹۵äᮡ

ྕญ௝Ł ❱݉⦹ᩍ ᱽ᫙᜽⎑݅.

2.3.2 ෹ੲվ

⪙ᦩŖᮡ ᰍഭӹ⩶᜾ᨱ঑௝ๅ✙۵14}, ࠭฾┽۵5}᳦ඹಽ

Ǎᇥ⦹Łᯩ݅. ⦹ḡอ⣩ᖩ᮹ᔍᬊᖒᮥɚݡ⪵⦹ʑ᭥⧕zᮡ

⩶᜾ᮝಽᯕ൉ᨕḡ۵Ŗᔍಽ݉ᙽ⯩᫙⩶ᱢྙ᧲ᯕӹᰍഭᨱ᮹⦽

Ŗ᳦ᮡ݉ᯝŖ᳦ᮝಽྗᨕๅ✙, ⪙ᦩት౎᝴ʑ, ᔍᕾ᝴ʑ, ࠭฾┽

᮹ 4aḡಽ Ǎᇥ⦹ᩡ݅.

2.3.3 ֜୺ࢄվ

Ǎ᳑ྜྷŖᮡ░❭ʑ, ࡹີᬑʑ, ⎹Ⓧญ✙┡ᖅ, Ñ⣙Ḳ, እĥ, ࠺ၵ ญ, ℁ɝaŖၰ᳑พ, ⮥šᱲ⧊ၰᇡᖅ, SHEET❭ᯝ᮹ݡ⢽Ŗ᳦ᮝ ಽ Ǎᖒࡹᨕ ᯩ݅. Ǎ᳑ྜྷŖ᮹ Ğᬑ ⦹⃽Ŗᔍෝ ঑ಽ Ǎᇥ⦹۵

äᮡ ᮹ၙa ᨧ۵ äᮝಽ ❱݉ࡹʑ ভྙᨱ ⦹⃽Ŗᔍෝ ⡍⧉⦽

༉ु ☁༊Ŗᔍᨱᕽ zᮡ ⣩ᖩᮥ ᱢᬊ⦹۵ äᯕ a܆⧁ äᮝಽ

ʑݡࡽ݅.

2.3.4 ऀ۩վ

ᇡݡŖݡ⢽Ŗ᳦ᮡ⎹Ⓧญ✙ˉʑ, ⪙ᦩት౎⨱ʑ, aྜྷสᯕ, aࠥᖅ⊹᮹ 4aḡಽ ݡ⢽Ŗ᳦ᮥ ᖁᱶ⦹ᩡ݅. aࠥᖅ⊹۵ Ǖ₊, ᱢᔍ, ᬕၹ, ⮺᝴ʑ, ჶ໕ᅕ⪙᮹ ☁Ŗ᯲ᨦॅಽ Ǎᖒࡹᨕ ᯩᮝ໑

ŖᔍᬊaƱ᮹ĞᬑaƱᯱᰍእ, ᅖŖ❱ᖅ⊹, ℁ɝaŖ᳑พ, Łᰆ ಆᅝ✙᳑ᯥ, všᦥⓍᱥʑᬊᱲ, H-PILE ⃽Ŗ⬥⧎┡, ☁ᔍ⃽Ŗ,

⣮⪵ᦵ⃽Ŗ, ᩝᦵ⃽Ŗ᮹᳑⧊ᮝಽǍᖒࡹᨕᯩ݅. ੱ⦽aྜྷสᯕ᮹

ĞᬑࠥǕ₊, ᱢᔍ, ᬕၹ, ⮺᝴ʑ, ჶ໕ᅕ⪙᮹☁Ŗ᯲ᨦॅಽǍᖒࡹ

ᨕᯩ݅. đŝᱢᮝಽ☁Ŗᔍ, Ǎ᳑ྜྷŖᔍ᮹ᖙᇡŖ᳦ॅ᮹᳑⧊ᮝಽ

Ǎᖒࡽݡ⢽Ŗ᳦ᮝಽ❱݉⦹ᩍ⎹Ⓧญ✙ˉʑ᪡⪙ᦩት౎⨱ʑࢱa ḡ Ŗ᳦ᨱ ݡ⧕ᕽอ ᯲ᨦ᳑ Ǎᖒŝ ᔾᔑᖒ ᳑ᔍෝ ⦹ᩡ݅.

3. đು

⦹⃽Ŗᔍ᮹ĞᬑྜྷᯕŖᔍᨱၙ⊹۵ᇩ⪶ᝅᖒᮡŖᔍĥ⫮ᙹพ

ᨱⓑᨕಅᬡᮥၽᔾ᜽┉݅. ⦹ḡอĞ⨹ᱢᱶᅕෝၵ┶ᮝಽ᯲ᨦ᮹

(10)

ᔾᔑᖒᱶᅕෝᔑ⇽⧁ᙹᯩᮥäᯕ௝۵ᱥᱽಽᩑǍෝ᜽᯲⦹ᩡ݅.

ᯝᅙ᮹⢽ᵡᅕŹ, ၙǎ᮹RS Meansෝ☖⧕᫙ǎ᮹ᱢᔑŝᱶᮥ

ᔕ⠕ᅕᦹᮝӹŖ᳦᮹ჵ᭥ᨱ₉ᯕaᯩŁ᯲ᨦ⩶┽, ǎaᄥᯱᩑ⪹

Ğᱢ᫵ᯙ॒₉ᯕᱱᯕᯩᨩ݅. ੱ⦽ᯝᅙ᮹Ğᬑᰆእ᮹᯲ᨦపᨱ

ၙ⊹۵᫵ᯙᮥᰆᧁᯩᮭ/ᨧᮭᱶࠥಽอǍᇥ⦹ʑভྙᨱ☁ప⪹ᔑ ĥᙹ, ᯲ᨦ⬉ᮉ, ქ┘ĥᙹ, ᔍᯕⓕ┡ᯥ॒ǎԕ᳑ÕŝእƱ⦹۵ߑ

⦽ĥa ᯩᨩᮝ໑, ၙǎ᮹ Ğᬑ ᰆእ᮹ ȽĊᯕ ǎԕ᪡ ᔢᯕ⦹ᩍ

ǎaᄥ ᔾᔑᖒ እƱ۵ ᱽ᫙᜽⎑݅.

ᅙᩑǍ۵⦽ǎ᮹ݡ⢽ᱢᔑྙ⨭ᯙ⢽ᵡ⣩ᖩᮥʑⅩಽḥ⧪ࡹᨩ

݅. ᩑǍđŝಽᔑ⇽ࡽ᯲ᨦ᳑ၰᔾᔑᖒᱶᅕ۵༉ࢱ⢽ᵡ⣩ᖩŝ

⦹⃽Ŗᔍᖅĥᝅྕ᫵ಚᨱᕽᱽ᜽⦹Łᯩ۵sᮥʑⅩಽ⦽äᯕ݅.

঑௝ᕽ ᅙ ᩑǍ᮹ ᯲ᨦపŝ ᝅᱽ Ŗᔍᨱᕽ ᱢᬊࡹ۵ ᯲ᨦపᨱ

₉ᯕaᯩ݅໕⣩ᖩ᮹}ᱶᯕ᜽ɪ⦹݅Ł⧁ᙹᯩ݅. ᯝᅙ᮹⢽ᵡᅕ Ź᮹Ğᬑᰆእ᮹᯲ᨦపᖁᱶᨱ۵100}ᯕᔢ᮹ᝅᱽŖᔍᔍಡෝ

ၵ┶ᮝಽ ⦹Ł ᯩ݅. ঑௝ᕽ ᅙ ᩑǍෝ ☖⧕ ᔑ⇽ࡽ ᯲ᨦ᳑ ၰ

ᔾᔑᖒᱶᅕᩎ᜽ḡᗮᱢᯙŖᔍᔍಡᇥᕾᮥ☖⦽ᙹᱶ·ᅕ᪥ᩑǍa

⦥᫵⦹݅.

qᔍ᮹ɡ

ᯕםྙᮡ2012֥∊ᇢݡ⦺Ʊ⦺ᚁᩑǍḡᬱᔍᨦ᮹ᩑǍእḡᬱ ᨱ ᮹⦹ᩍ ᩑǍࡹᨩᮭ.

References

Ahn, J. S., Lee, J. H., Kim, Y. S., Tae, Y. H. and Lim, H. S. (2009).

“A study on the improvement of revision process and depreciation method of the construction standard estimating system.” Journal of the Architectural Institute of Korea, Vol. 25, No. 8, pp. 195-204 (in Korean).

Chou, J. S. (Rayson) (2005). Item - Level quantity - Based preliminary cost estimating system for highway earthwork, land scape, subgrade treatmenents base, surface courses, Pavement And Traffic Control (in Korean).

Ha, G. J., Choi, M. K., Yi, D. R., Ha, M. S., Ha, J. H. and Kim, J. H.

(2007). “A study on the work crew combination for rational cost estimation of construction -Focused on the cement watertight construction of public housing-.” Structural System of Conference paper of the Architectural Institute of Korea, Vol. 29, No. 1, pp.

661-664 (in Korean).

Jung, D. K., Tae, Y. H., Ahn, B. R. and Cho, Y. H. (2009). “A study on the standard of cost estimation in the construction of pavement and maintenance.” Journal of the Korean Society of Road Engineers, Vol. 11, No. 1, pp. 85-94 (in Korean).

KICT (2009). Construction standard quantity (in Korean).

Kwon, S. C., Kyung, K. S., Kim, K. J. and Park, H. Y. (2007).

“Evaluation of economical efficiency of standard quantity per unit by change of resource quantity per unit.” Journal of the Korean Society of Civil Engineers, Vol. 27, No. 4D, pp. 517-524 (in Korean).

Park, H. S., Han, Y. L., Huh, Y. A. and Ahn, B. R. (2008).

“Estimation of construction equipment production rates: Focus on efficiency rate.” Journal of the Korean Society of Civil Engineers, Vol. 28, No. 1D, pp. 67-72 (in Korean).

Rs, M. (2006). Heavy construction cost data (20th Annual Edition).

수치

Table 1. Representative Classification of River Conservation Work
Fig. 1. Rs Means Structure in America
Table 3. Existing Standard of Estimate
Table 6. Work Crew-Combination in Revetments and Productivity Information
+4

참조

관련 문서

대한의사협회 회원자율징계제도에 회원자율징계제도에 대한 대한 토론회 토론회 개최하 개최하 여 여 전문가단체의 전문가단체의 회원징계제도에 회원징계제도에 대한

This study examines the effect of previous work experience on the long-lived venture firm called 'Good Quality startup'. The research explores entrepreneurs of

– Contractors work on the project and get reimbursed by the owner for costs, plus additional agreed-upon fees. – Usually used when the scope of work is difficult to define –

– Contractors work on the project and get reimbursed by the owner for costs, plus additional agreed-upon fees. – Usually used when the scope of work is difficult to define –

Resource Based Construction Rate Work Based. Construction

– Late Finish (LF): latest possible time an activity can finish based on the logic and durations identified in the network without extending the completion date of the

• Apply the principle of work and energy between the initial position and the point at which the spring is fully compressed and the velocity is zero. The only unknown in

Web-based network of career counseling includes the CareerNet developed by the Korea Research Institute for Vocational Education and Training, the Worknet of the Work
